Project Control Suite data model

Prev Next

Project, task, and details are stored in table 1003: ProjectPlanning Line. Microsoft Dynamics 365 Business Central recognizes three types of that line: Budget, Billable, and Both Budget and Billable.

Because Industrial Equipment Manufacturing (JMS) clearly separates budget, planning, and billing, an additional type has been added: Planning. The Both Budget and Billable type is hidden. Industrial Equipment Manufacturing previously had separate tables for budget and billing lines; these no longer exist.

The Copy Budget to Planning action copies a planning line of the type Budget to a new planning line of the type Planning by changing the type.

Table 1003 can grow quite large. To accommodate this, the following archiving rules apply:

  • When a project quote is converted to an order, only the active budget is copied. All other budget versions are archived.

  • When a project is completed, all planning line types are archived.

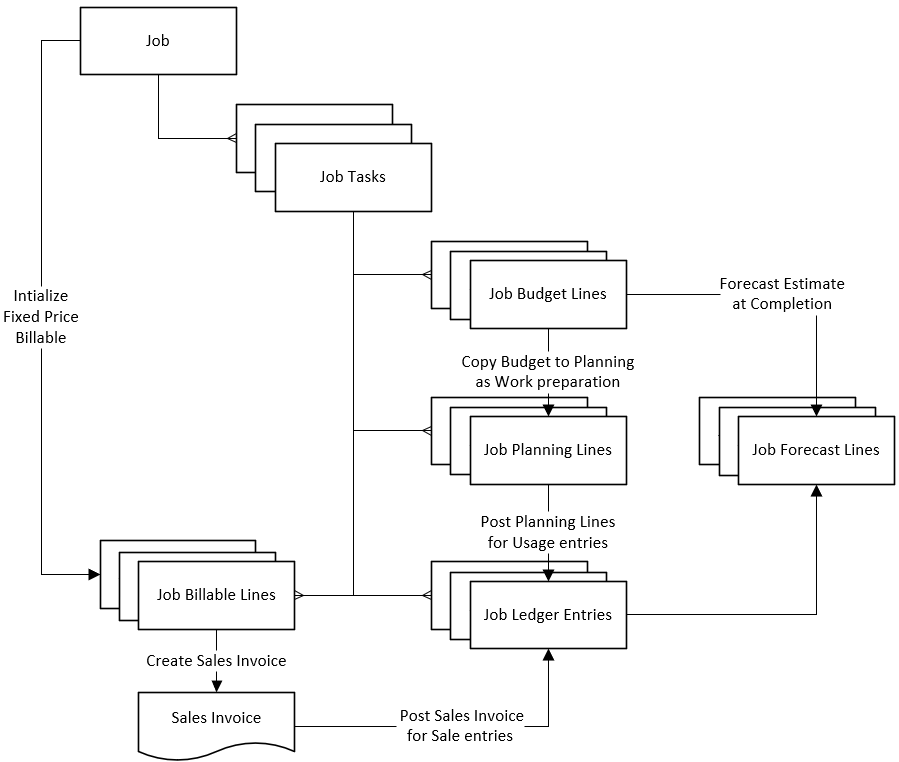

Project Control Suite Data Model

In Industrial Equipment Manufacturing, the planning line has three types: Budget, Billable, and Planning. The line type is not editable but is set per page:

  • In the Budget Lines page, you can only create lines of the type Budget.

  • In the Planning Lines page, you can only create lines of the type Planning.

    • Planning lines are also created by the Copy to Planning Lines action.

  • In the Billable Lines page, you can only create lines of the type Billable.

    • Billable lines are also created by the Initialize action that breaks down a contract amount.

    • Billable lines are also created when usage is posted in a project with invoicing method Time and Material.
